|
|
|
|
Citizens Concerned About the Future of the Etobicoke Waterfront
|
|
|
|
|
Updated: May 2, 2016
|
|
|
|
|
|
|
|
|
|
|
|
|
October 26, 2011
The TRCA have just published the Fall 2011, Mimico Waterfront Park Community Newsletter on their website. It includes the following construction update:
• This July, TRCA started construction of the second phase of the Mimico Waterfront Park in Toronto’s west end. The construction area stretches from Superior Avenue Parkette to Lakeview Promenade Park/Humber Bay Park West. • Over the summer months, TRCA began to create the land base for the new park. Since operations began, 580 loads of rubble material have been received at the site. • Lakefilling will continue into the fall and will follow with the construction of the three cantilevered boardwalk sections in the winter months. • Access to parts of the shoreline at Lake Promenade Park will be closed for the removal of the existing dock wall and reshaping of the shoreline. As well, the gazebo will be lifted and relocated approximately 25 metres onto the newly created land base at the very eastern edge of the new park. • This project is funded by Waterfront Toronto as part of waterfront revitalization and is expected to be completed by next fall. • For the public’s safety, access to the construction site has been restricted to authorized personnel only, and will remain closed to visitors until construction is completed.
|
|
|
|
|
August 13, 2011

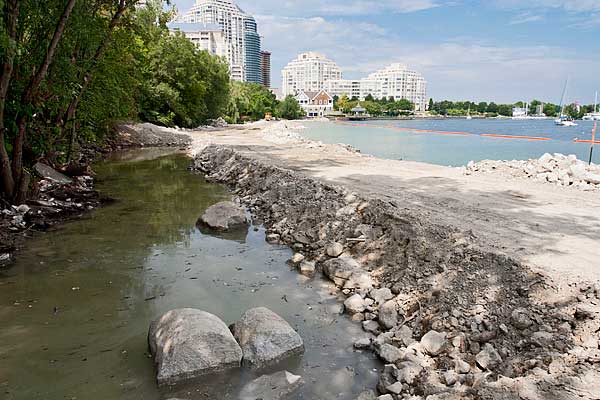

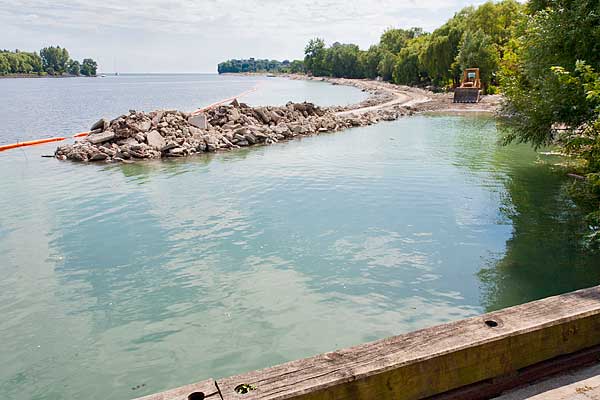

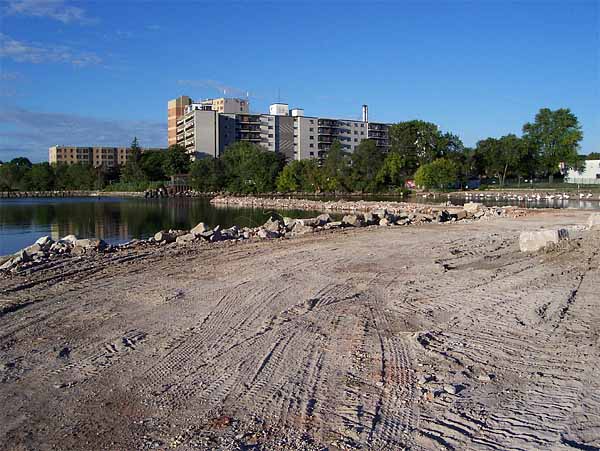

These images from August 13 show the shoreline edge construction almost complete to Grand Harbour. Once the edge is complete, filling behind will begin.
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Phase II Construction Begins
On July 4, work will finally begin on Phase 2 of the Mimico Linear Park. On June 20, the TRCA officially acquired the final piece of shoreline to allow completion of the long-awaited park.

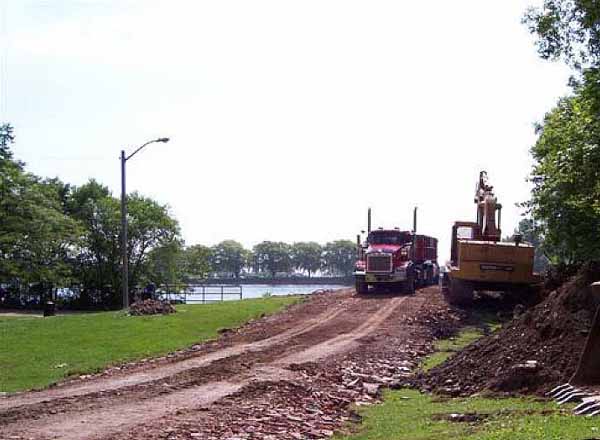

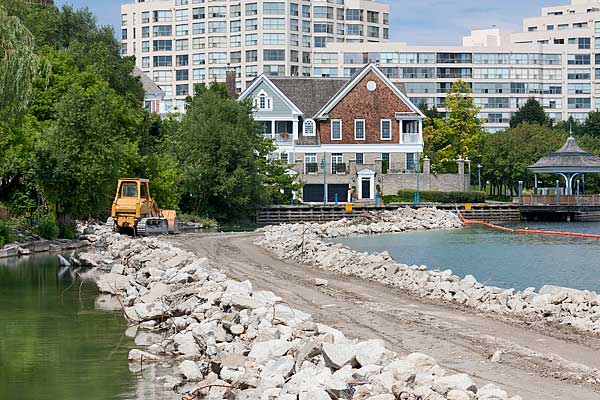

The construction entrance will be at Superior Ave. The first phase of construction will be building the armourstone shoreline. Once that is complete, they will fill the area between the existing shoreline and the armourstone. The plan calls for the existing gazebo near Grand Harbour to be moved further into the lake and the public area around it to be enlarged. The area will be closed to the public when work on this section begins later this summer. Reconfiguring this area is intended to improve traffic flow and reduce pedestrian/cyclist collisions
|
|
|
Phase I is Open!

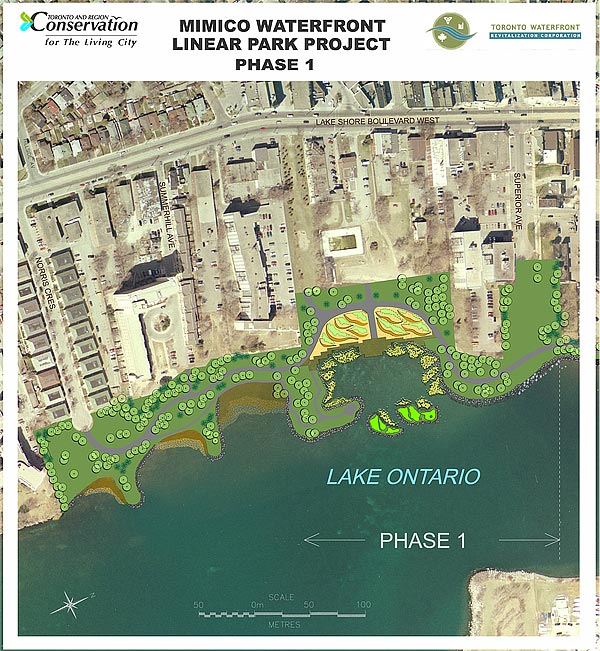

On Monday, July 28, 2008, Phase I of the Mimico Waterfront Linear Park was officially opened, 2 years and 4 days after the ground breaking ceremony. This phase runs from Norris crescent in the west to Superior Avenue on the east end. The largest portion o the park is adjacent to Amos Waites Park. This is where you will find a large cantilevered boardwalk overlooking a protected wetland embayment area. On the land side of the boardwalk is a small sand dune habitat.
The paved Waterfront Trail runs through the park and several unpaved side trails run off from it to the cobble beaches and rocky headlands.
You can pan and zoom on the image below for a panoramic view of the park on opening day (after most of the people had left). (requires Flash player)
|
|
|
|
|
|
|
|
|
November 2006 Progress Report

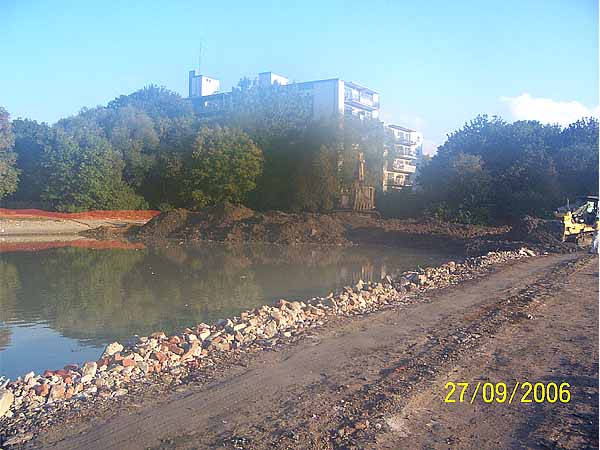

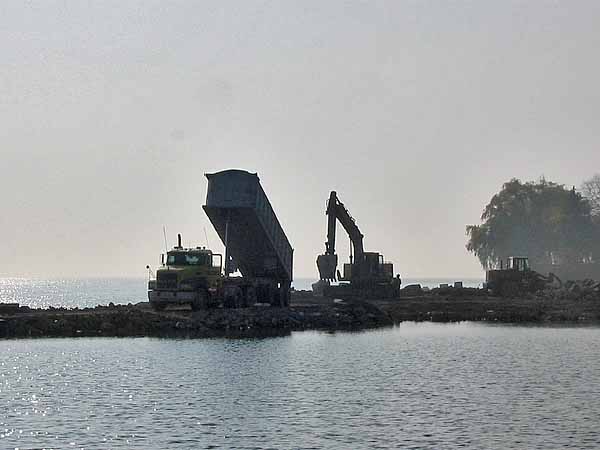

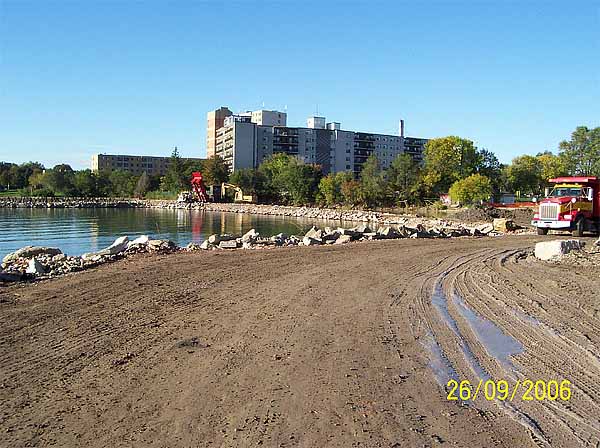

The lakefilling for Phase 1 of the Mimico Linear Park is now almost complete. As of November 20th, 4704 loads of fill (rubble and earth) had been used. All loads are inspected before and after unloading to make sure they are uncontaminated and suitable for use as lake fill.

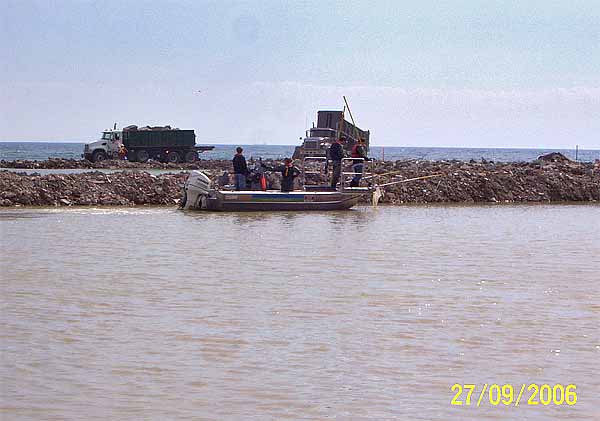

A construction access road now cuts off the embayment area from the rest of the lake. Before it was completely closed off, the TRCA sent in an electro-fishing team to make sure there were no fish left inside. By sealing off this area, they will be able to work on the embayment area next spring. Conservation regulations prohibit disturbance of the lake bottom during the breeding season, but now this area is temporarily not part of the lake.
Later next summer or fall, the construction road will be removed, leaving just the string of habitat islands across the mouth of the wetland embayment.

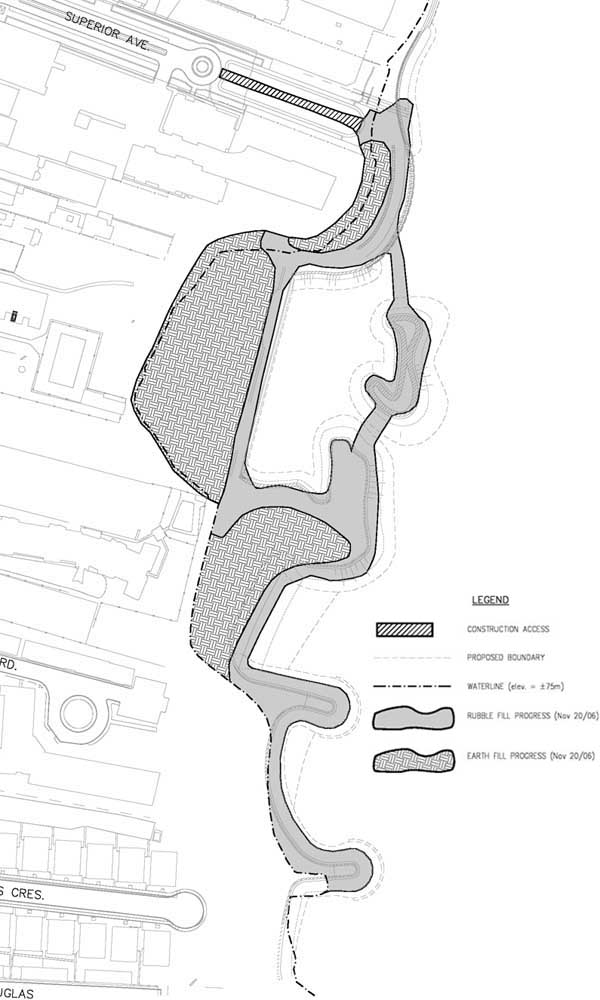

The drawing below shows the fill status as of November 20, 2006. Click on the drawing for the full status drawing (2.5 MB pdf)
|
|
|
|
The TRCA has posted construction bulletins on their website:
Also, you can check the TRCA website for more information on this exciting new project in Mimico.
|
|
